7/11/25 – Wind South
Foundations Excavated – 633/94%
Foundation Pours Complete – 564/84%
Foundations Backfilled – 557/83%

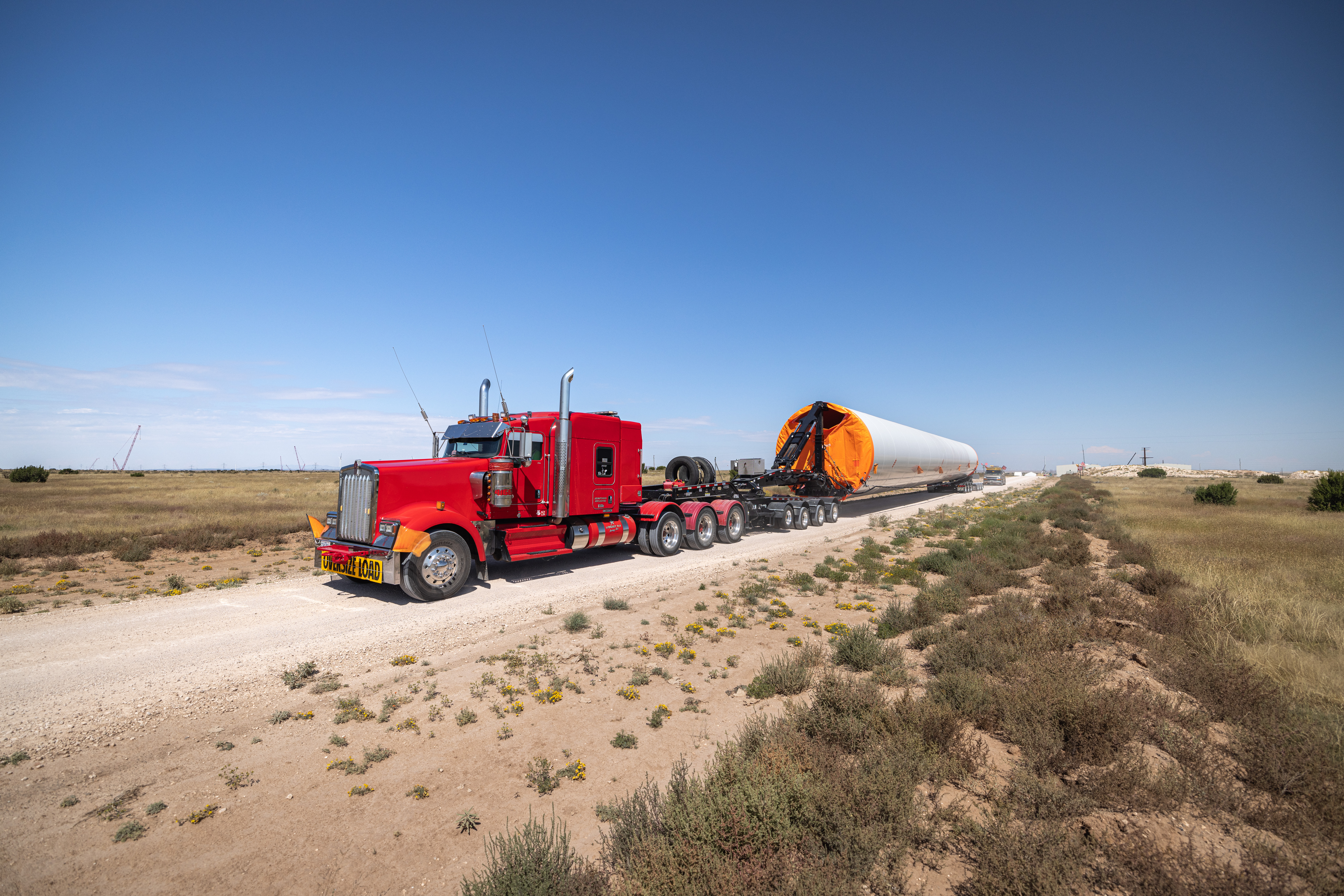

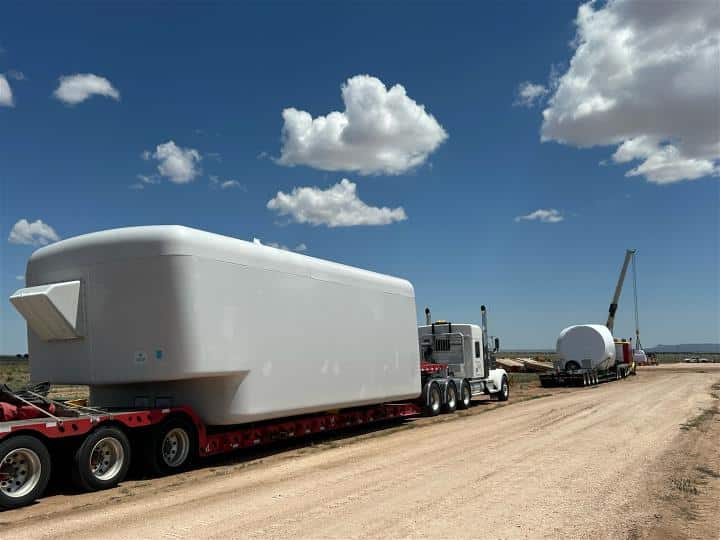

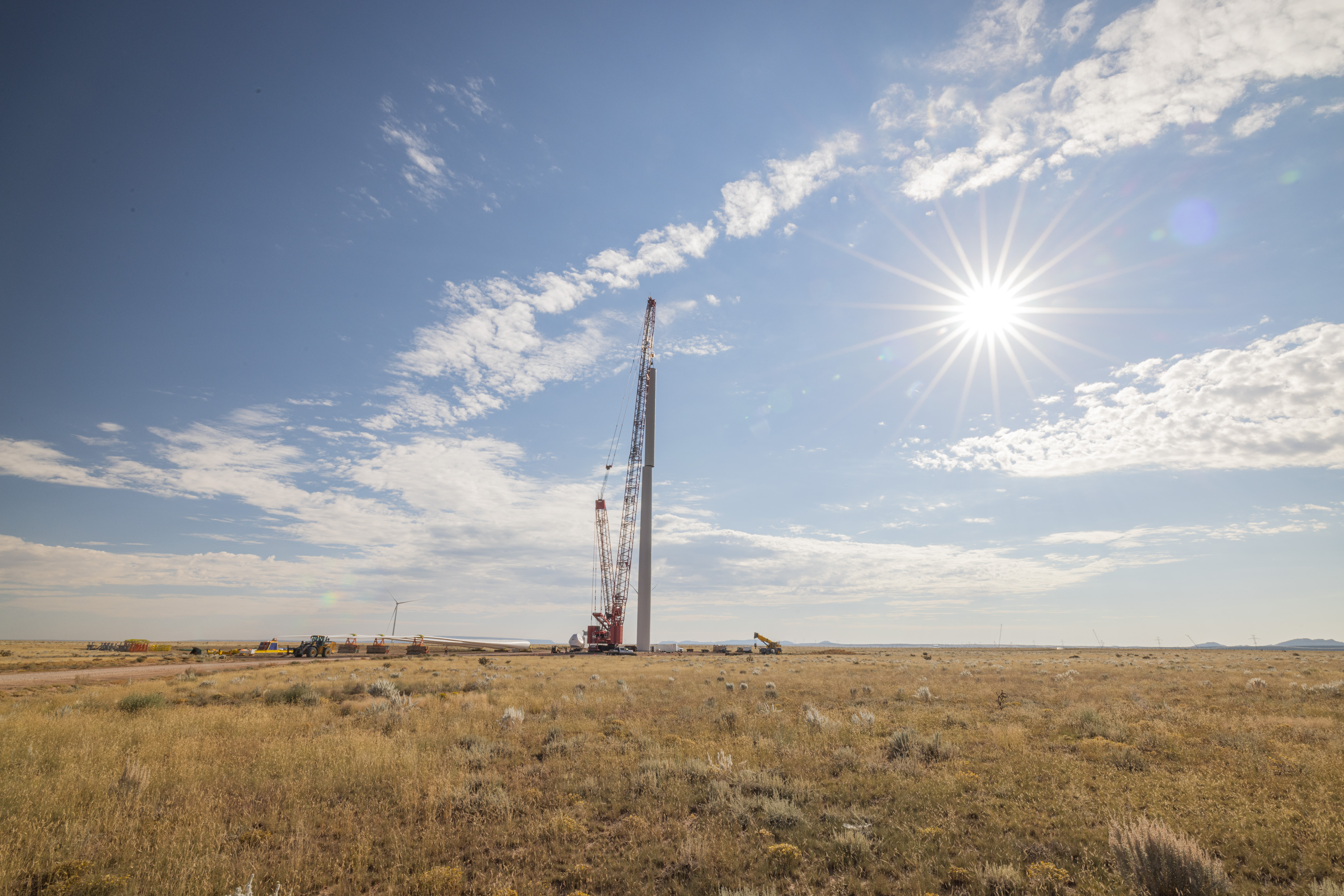

Turbines Delivered – 454/67%

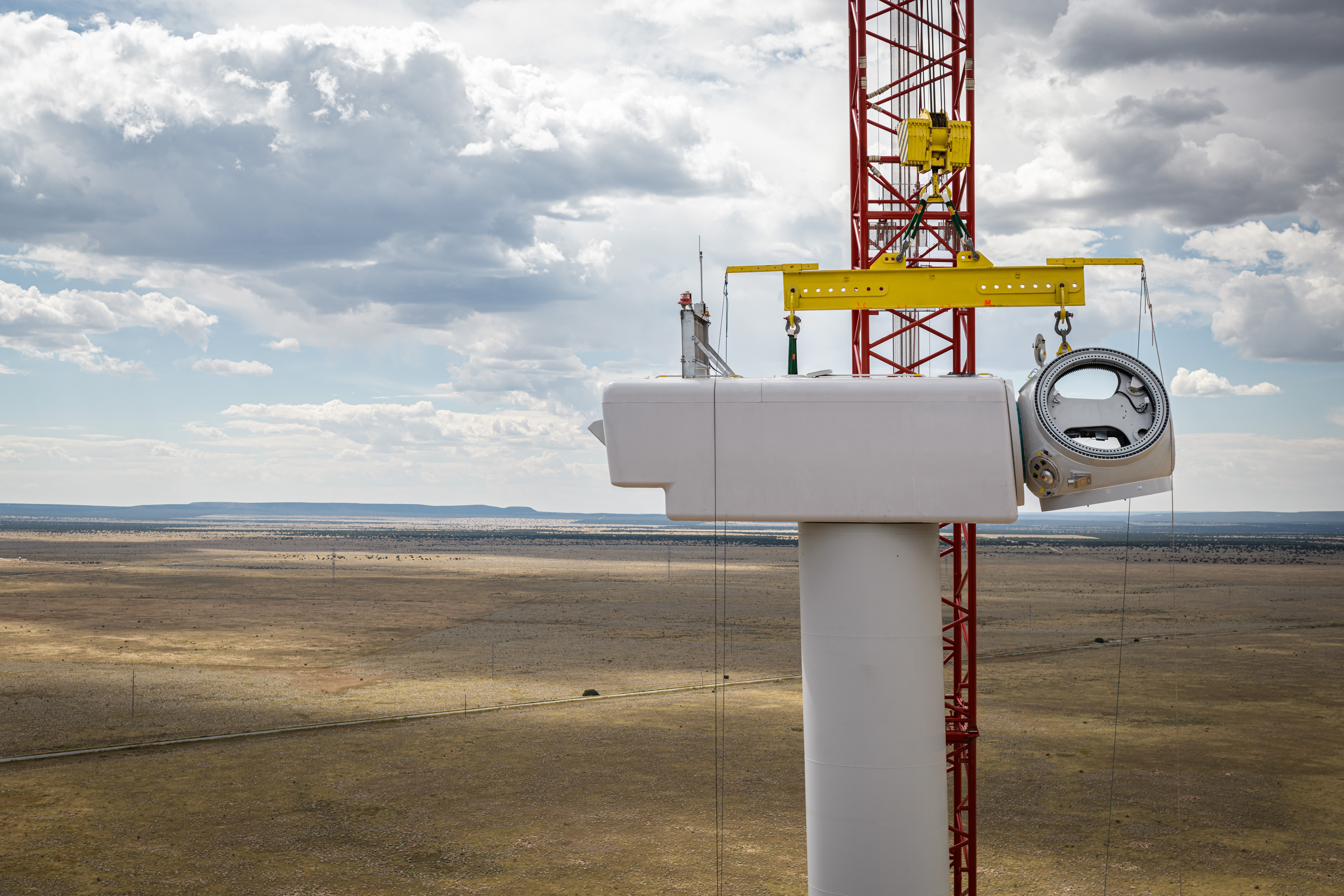

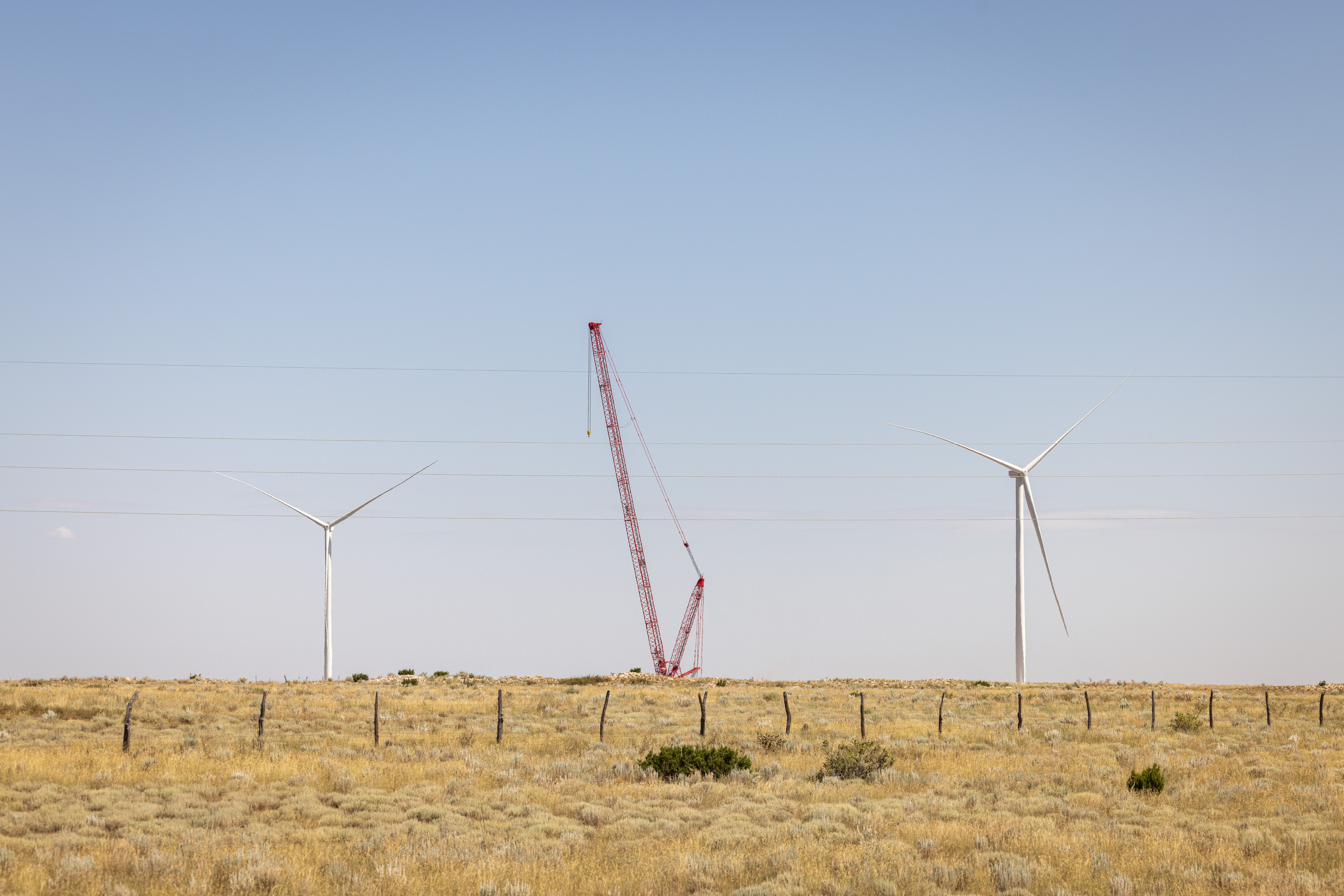

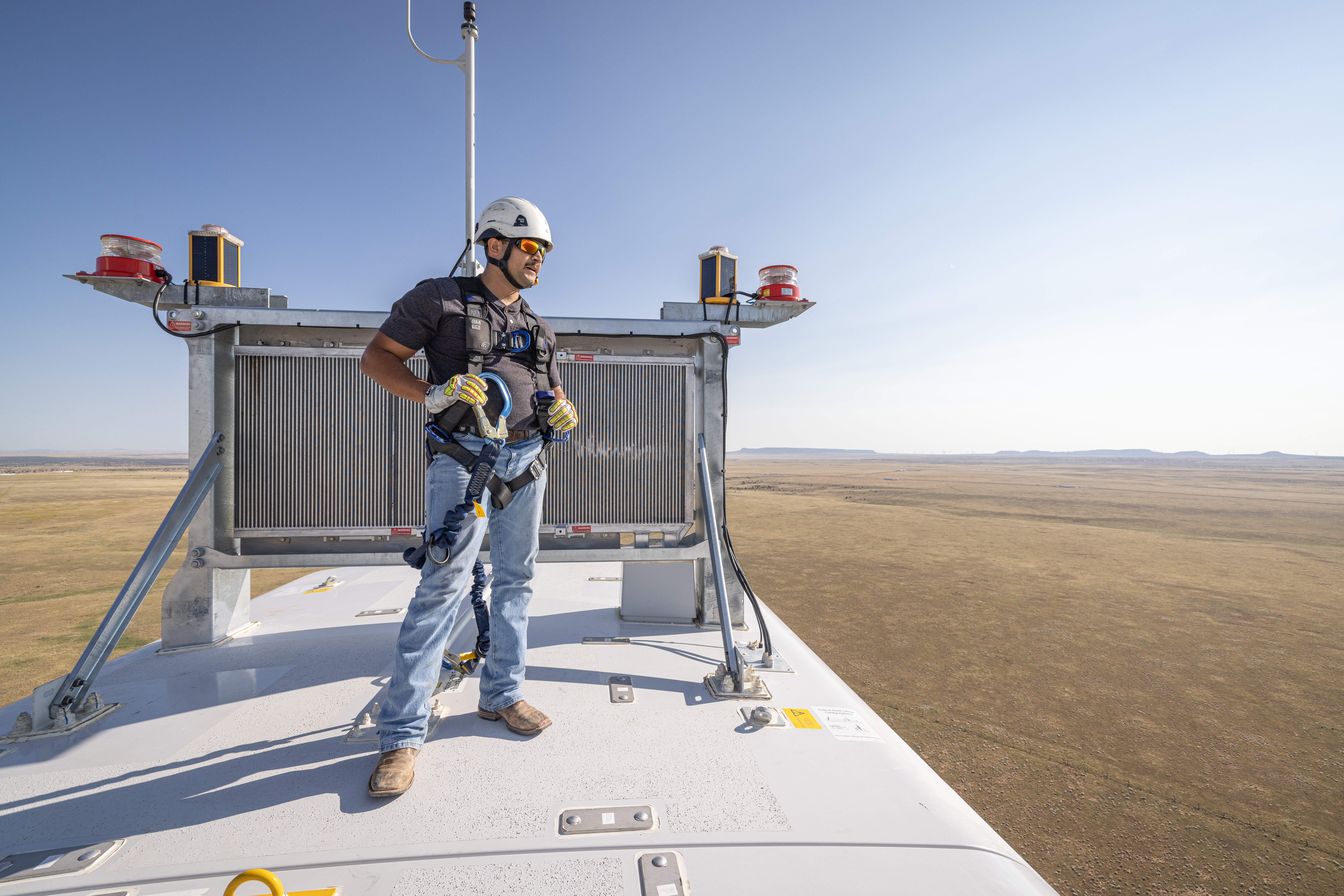

Turbines Erected – 220/33%
Underground Collection System Installed – 1,817,723 LF / 64%
Overhead Collection Structure Install 558/54%

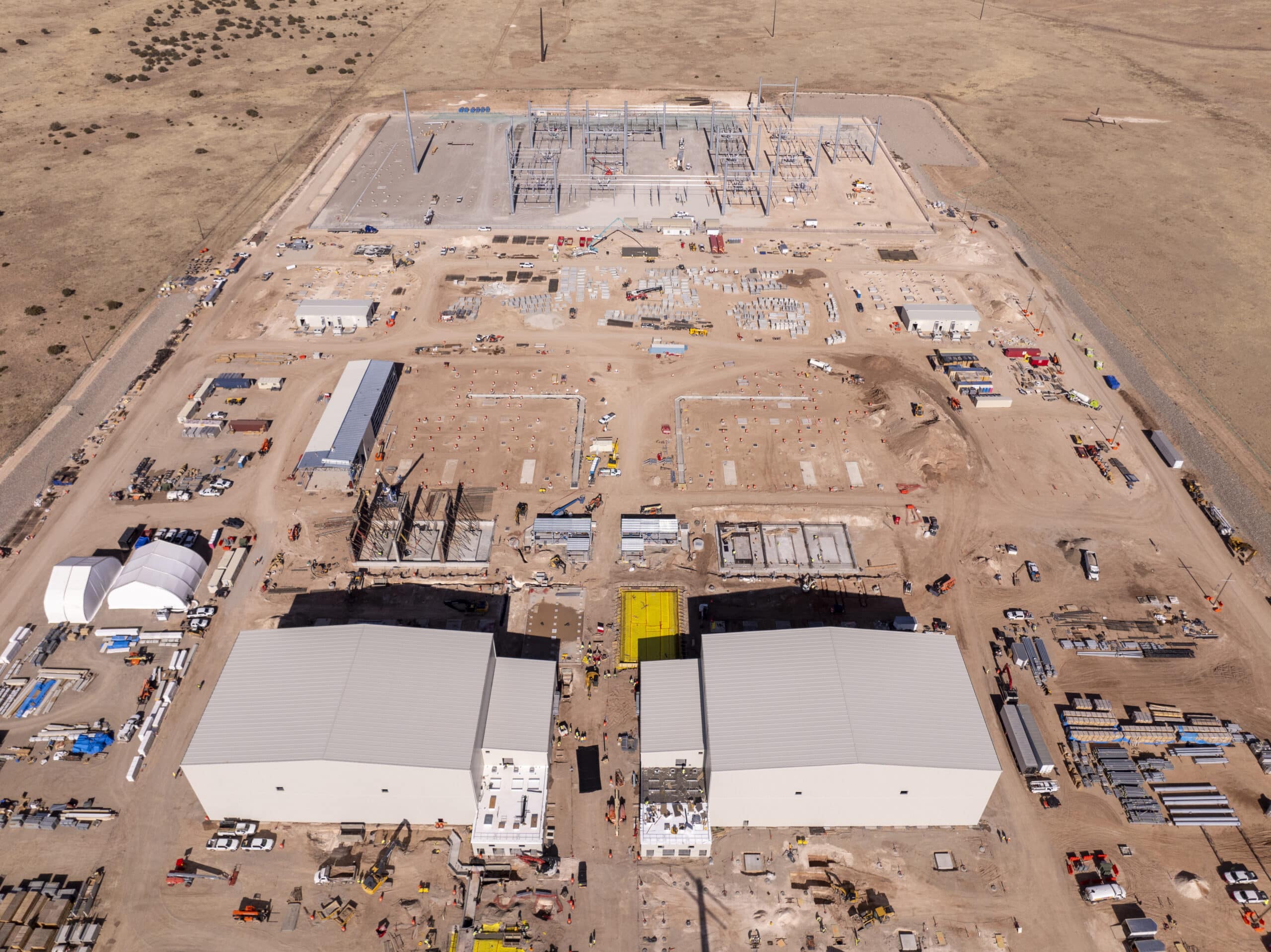

Substation Completion (7 total) – 82%
-
1/17/25 – Wind North
Foundations Excavated – 166/69%
Foundations Poured – 137/57%
Foundations Backfilled – 127/52%
UG Collection Systems Installed – 241,533 LF/21%
OH Collection Structures Installed – 38/6%
-

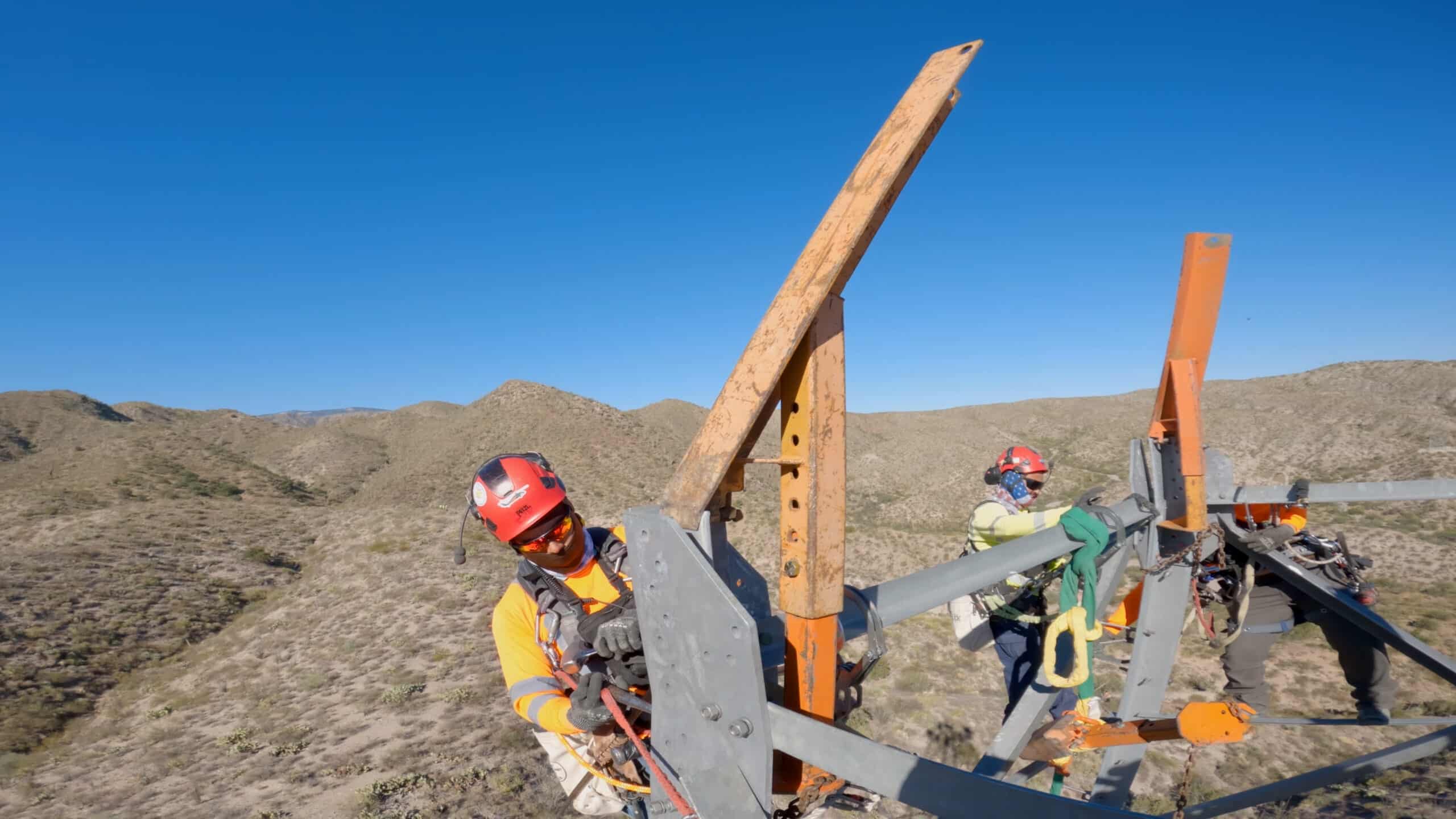

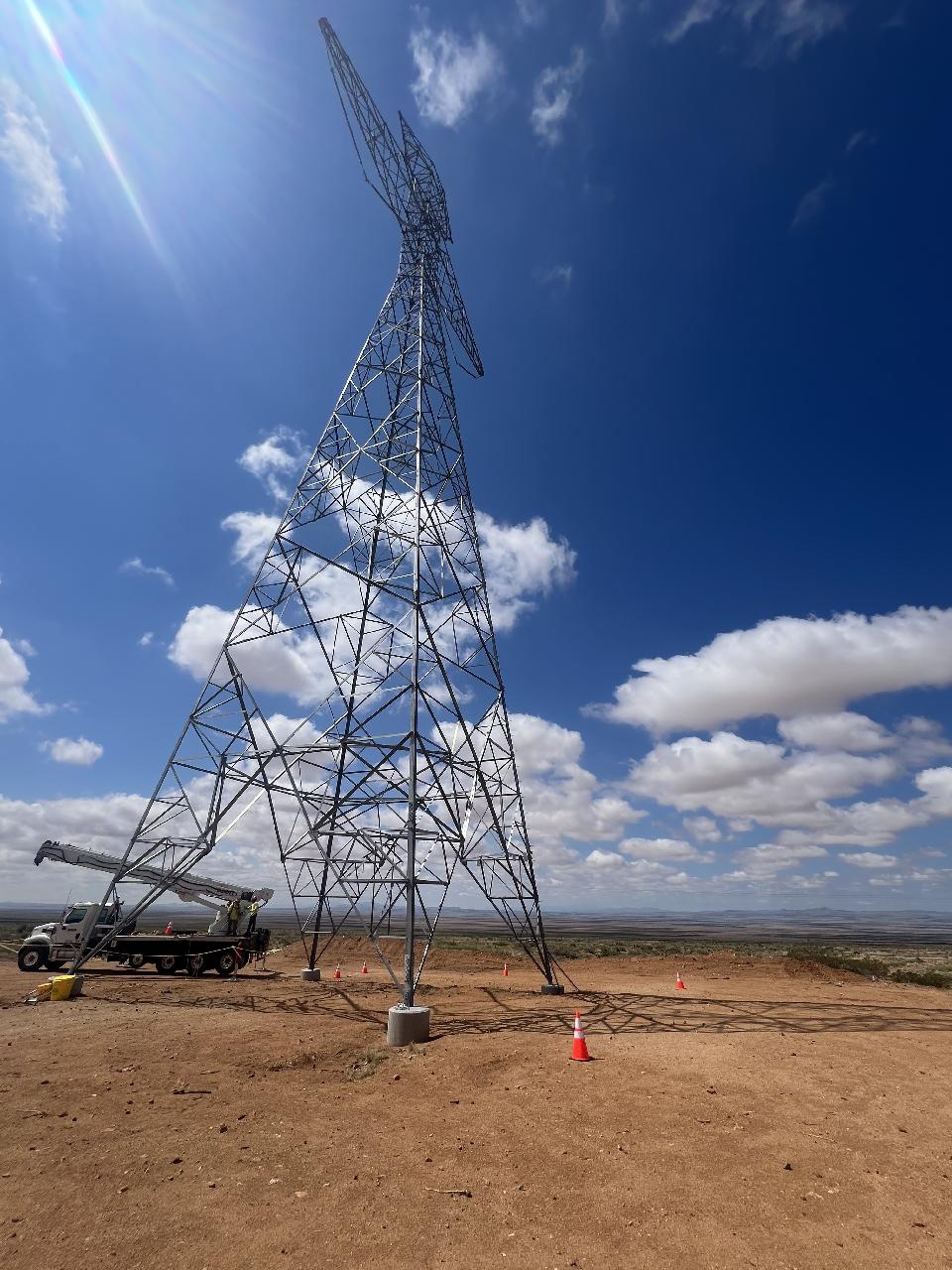

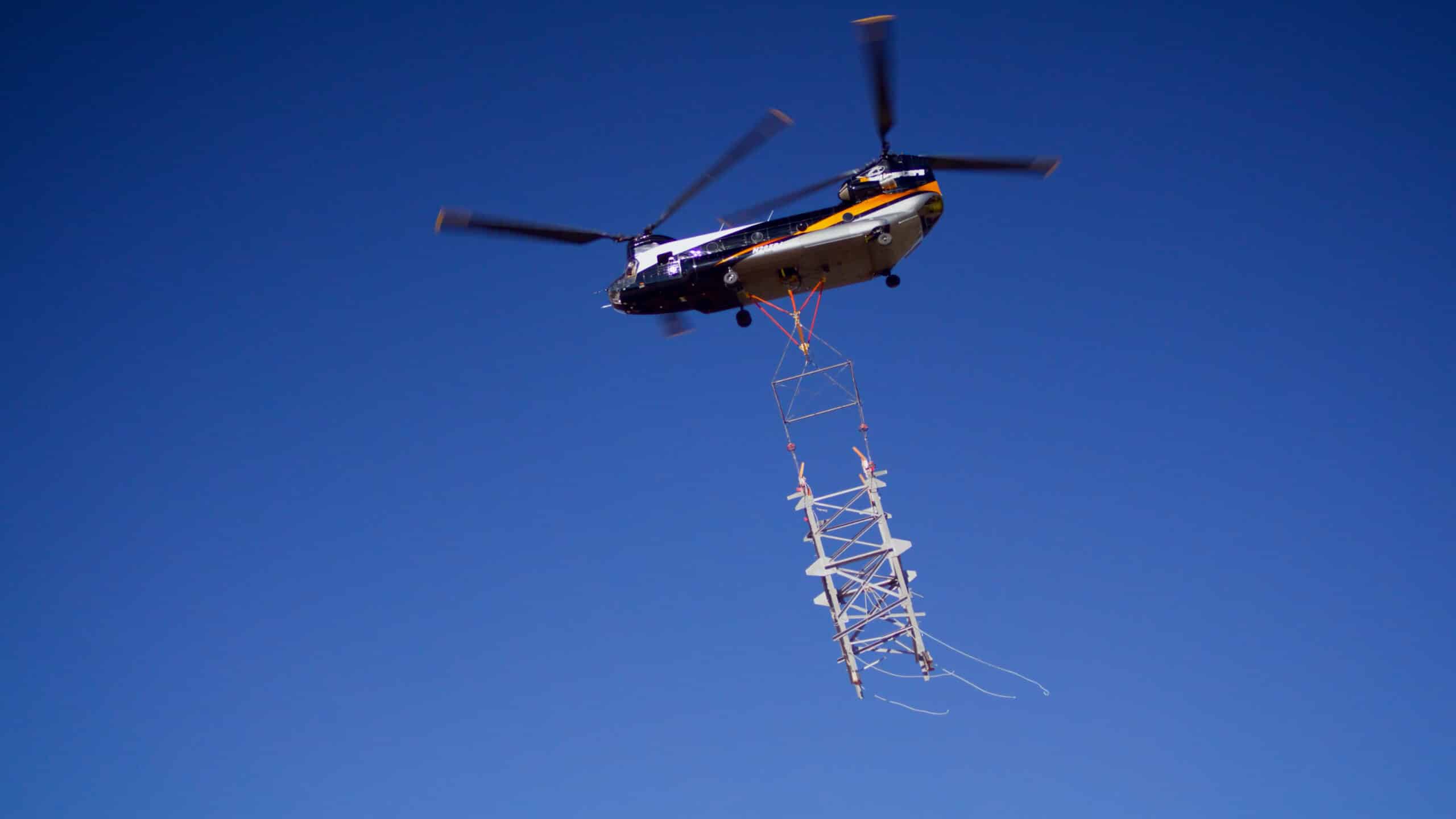

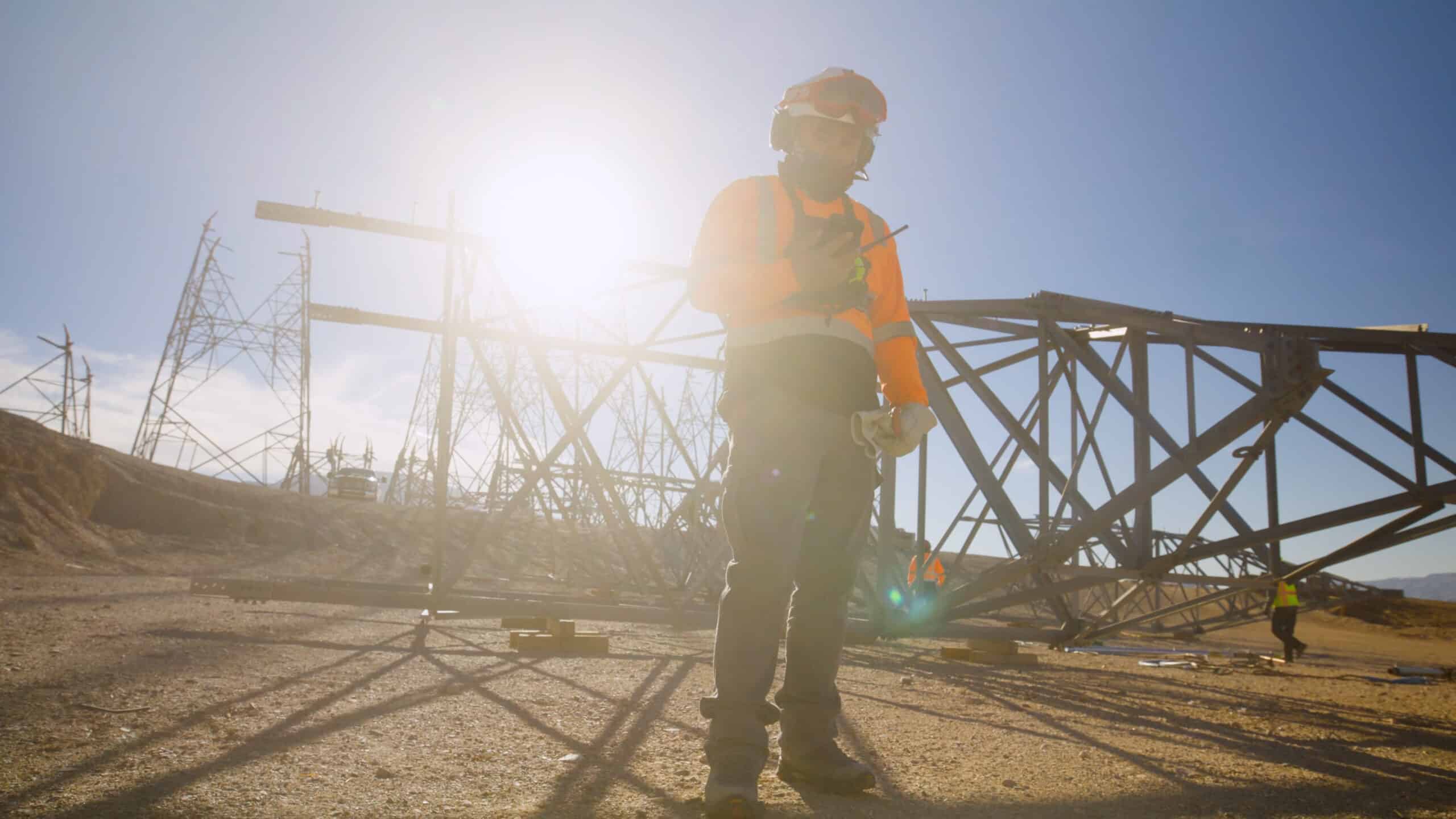

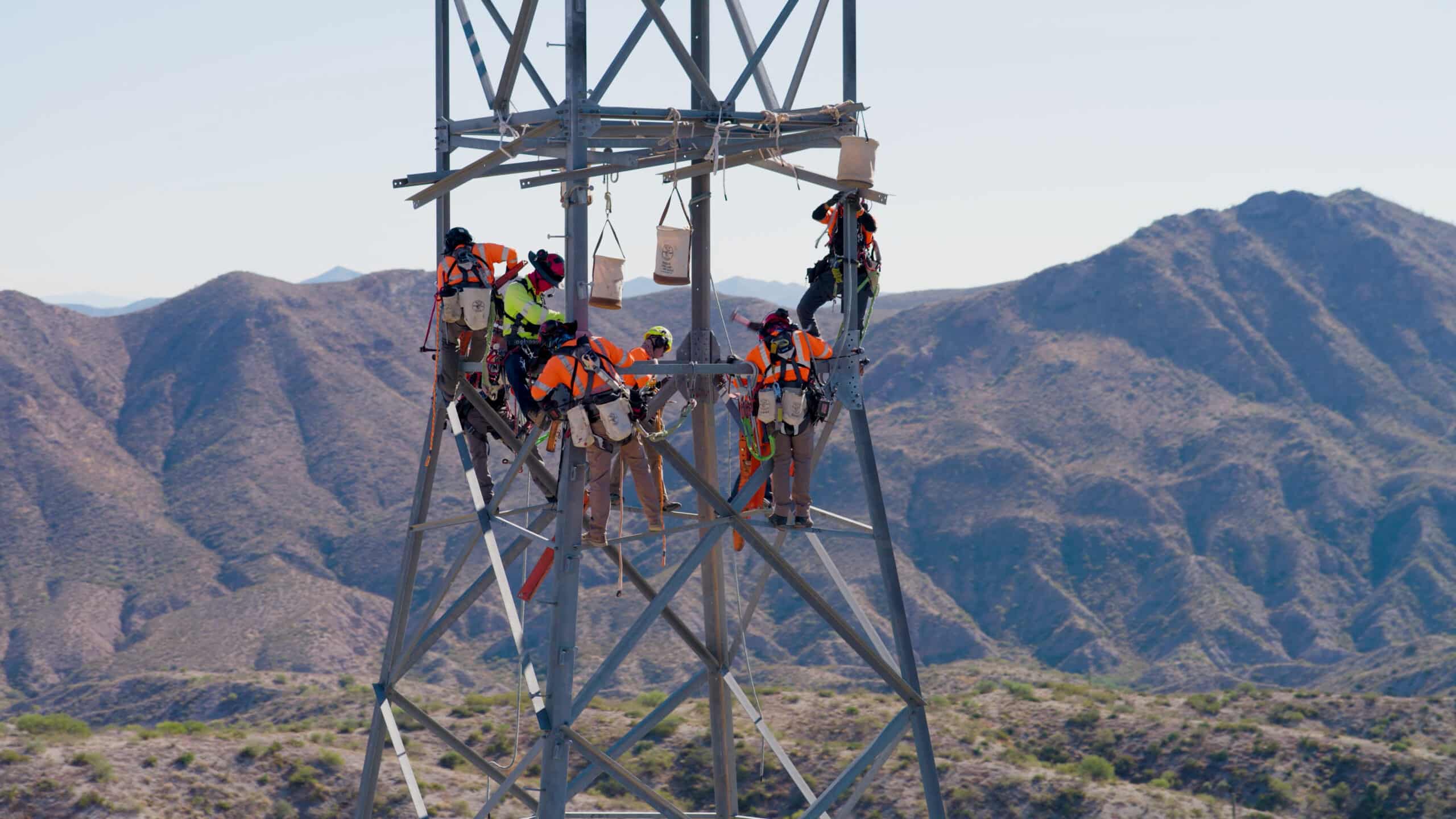

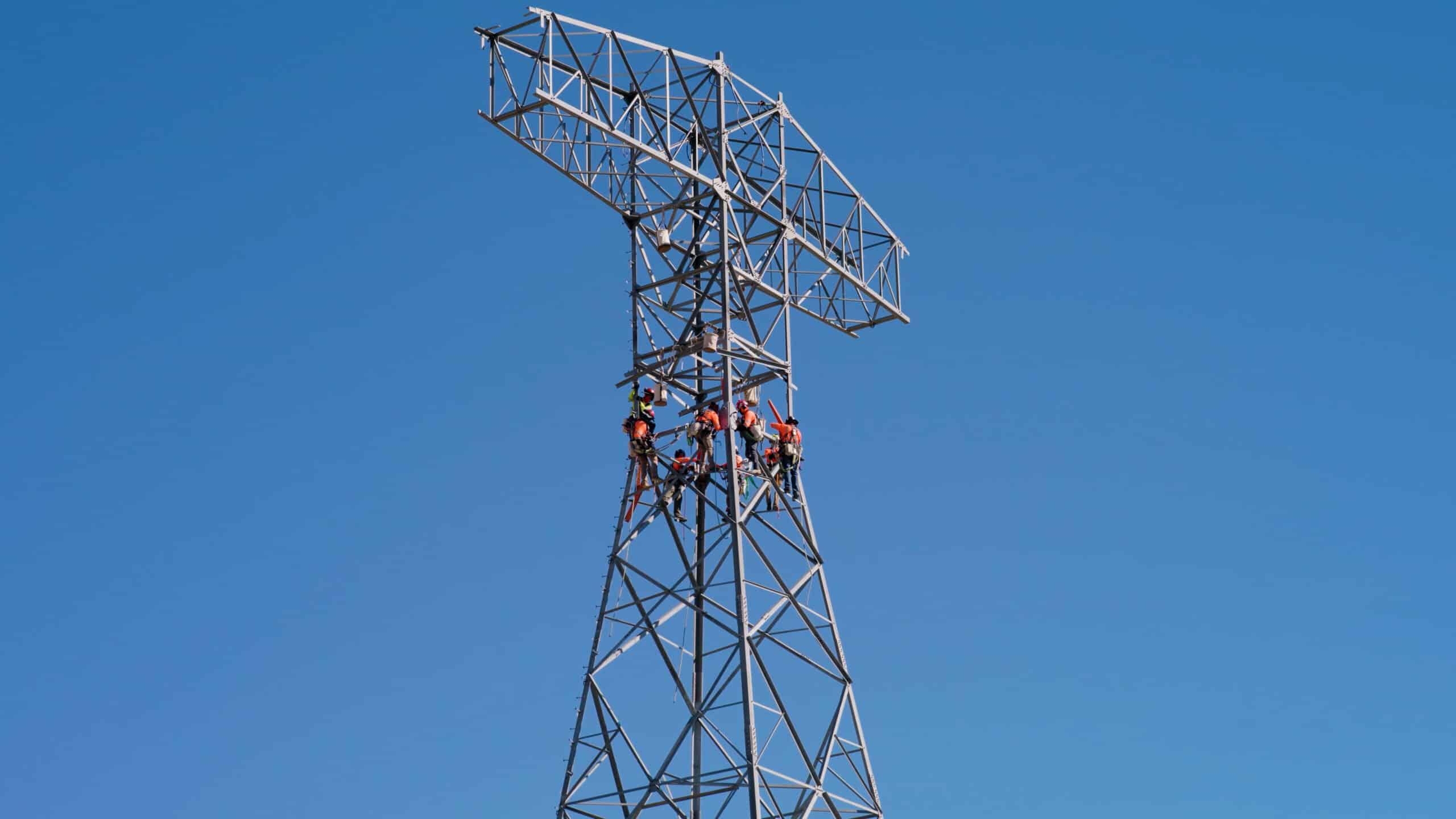

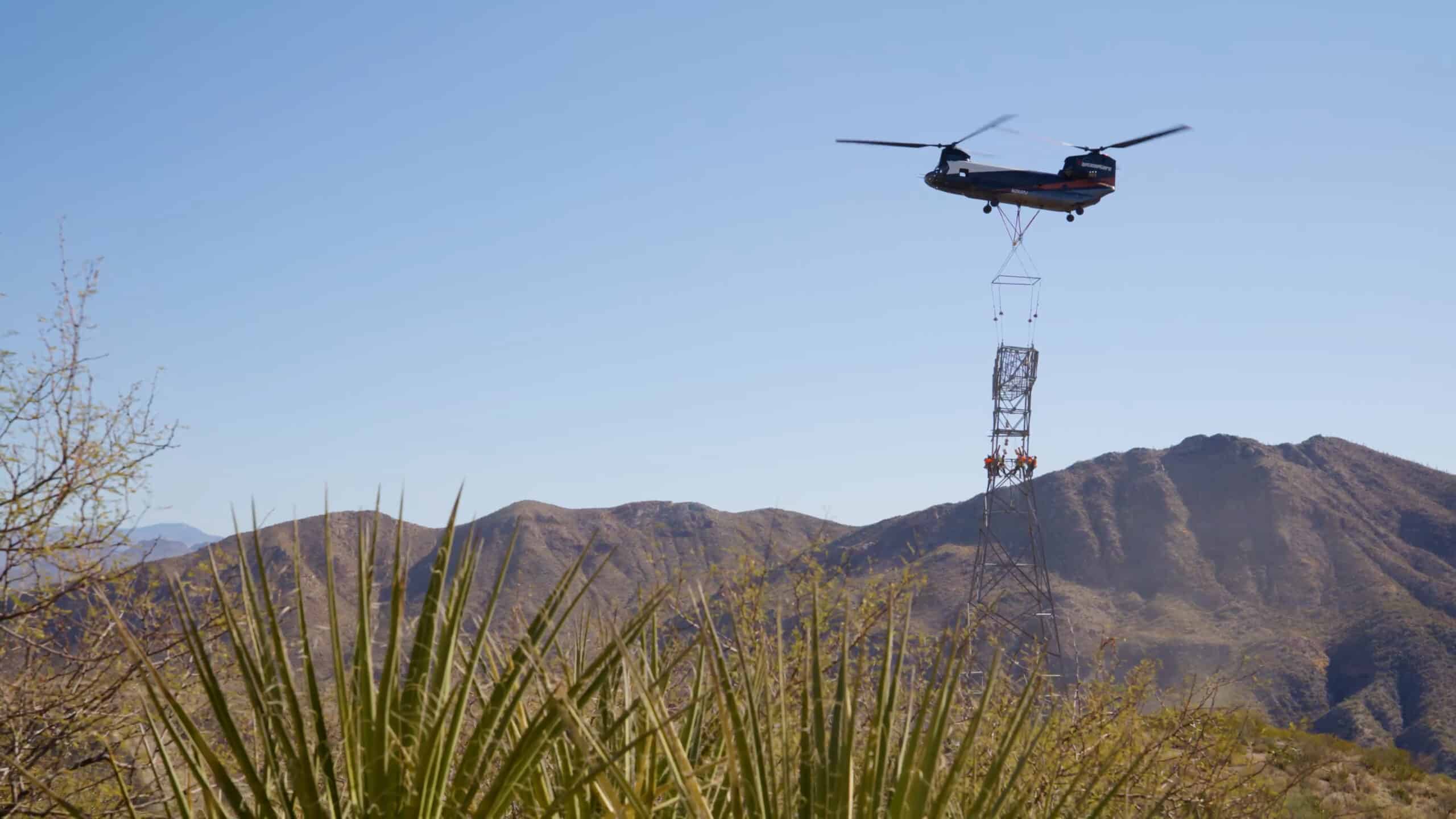

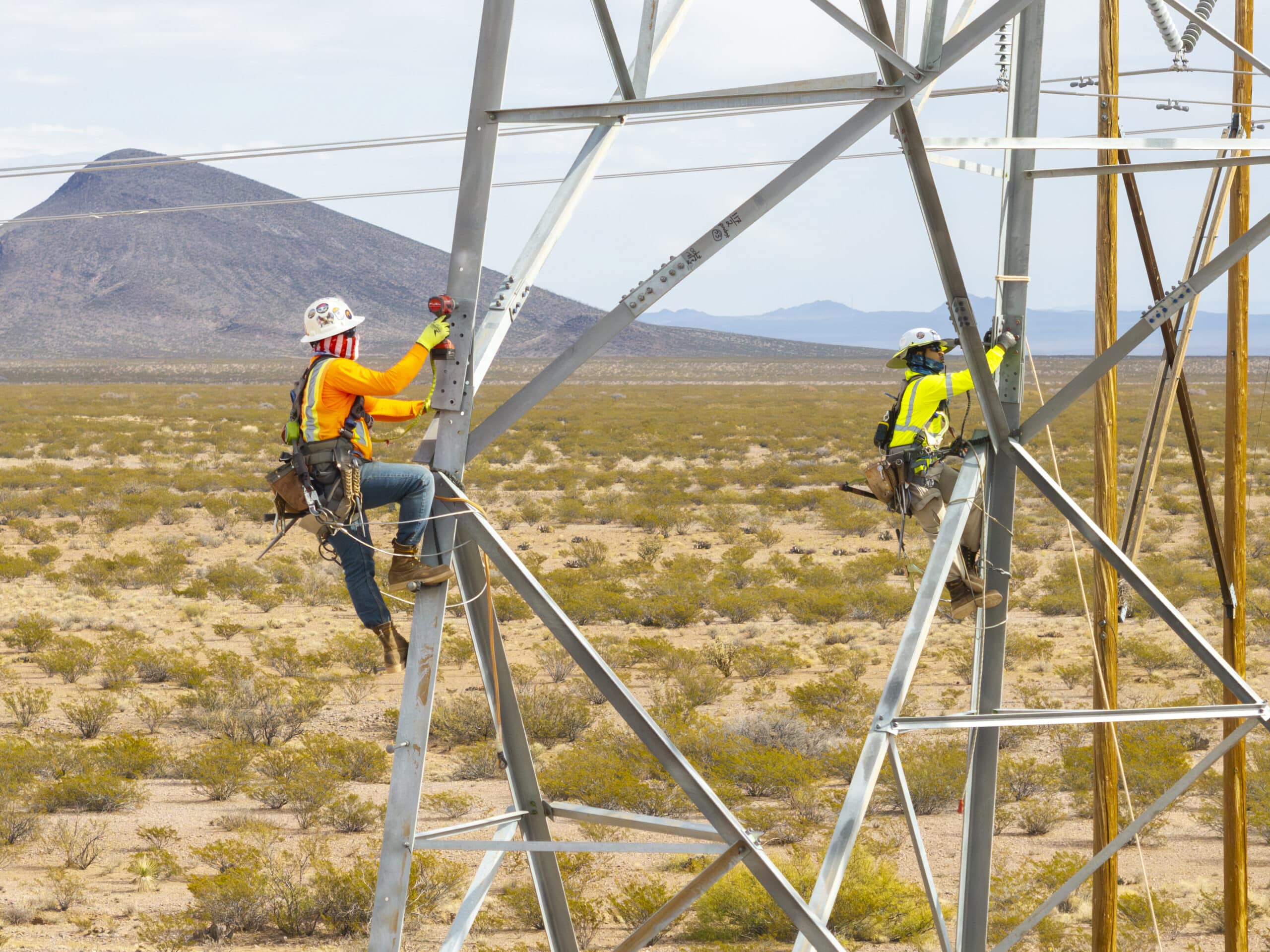

6/30/25 – T-Line
Foundations Complete – 100%
Anchors Installed – 100%

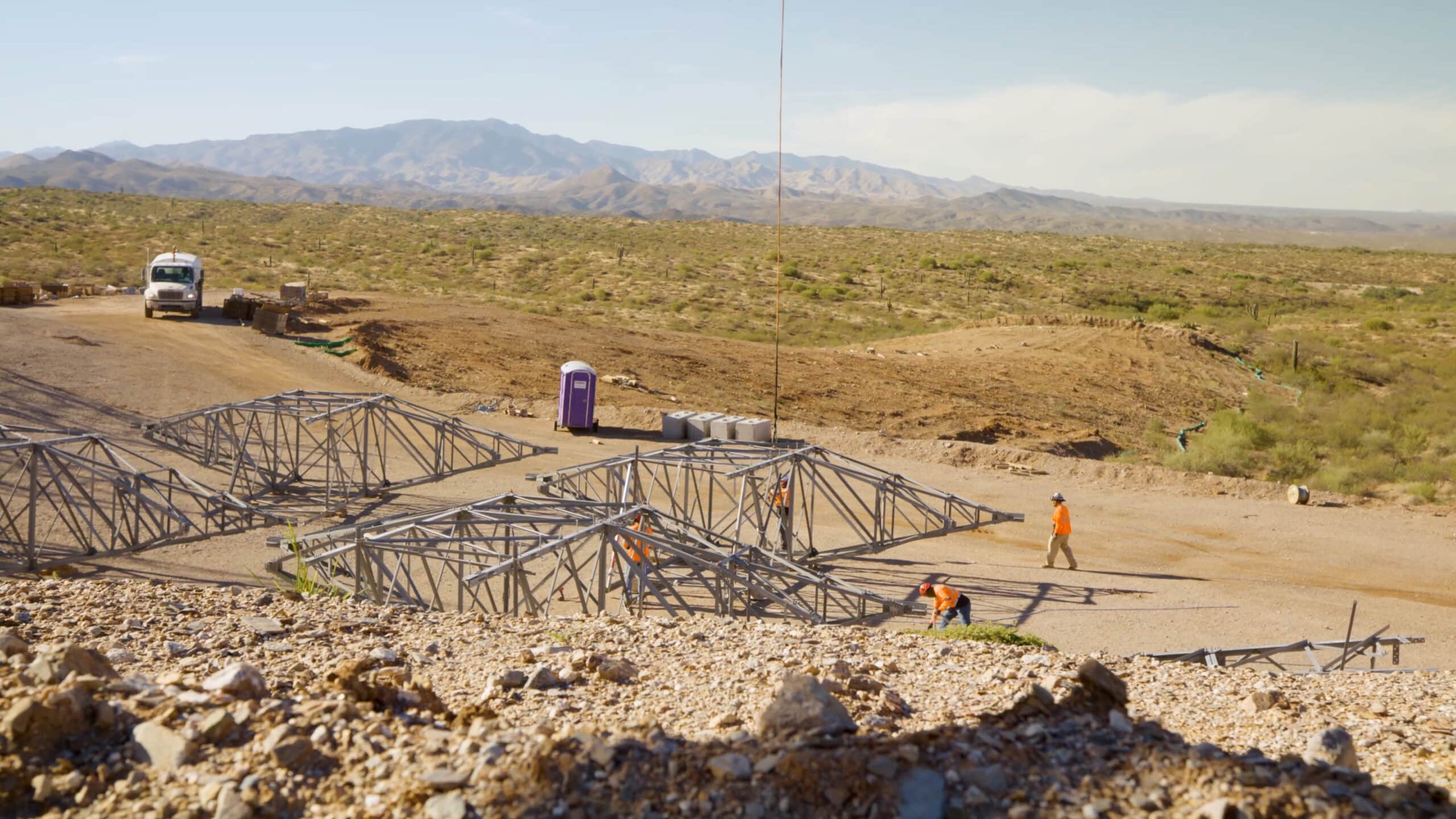

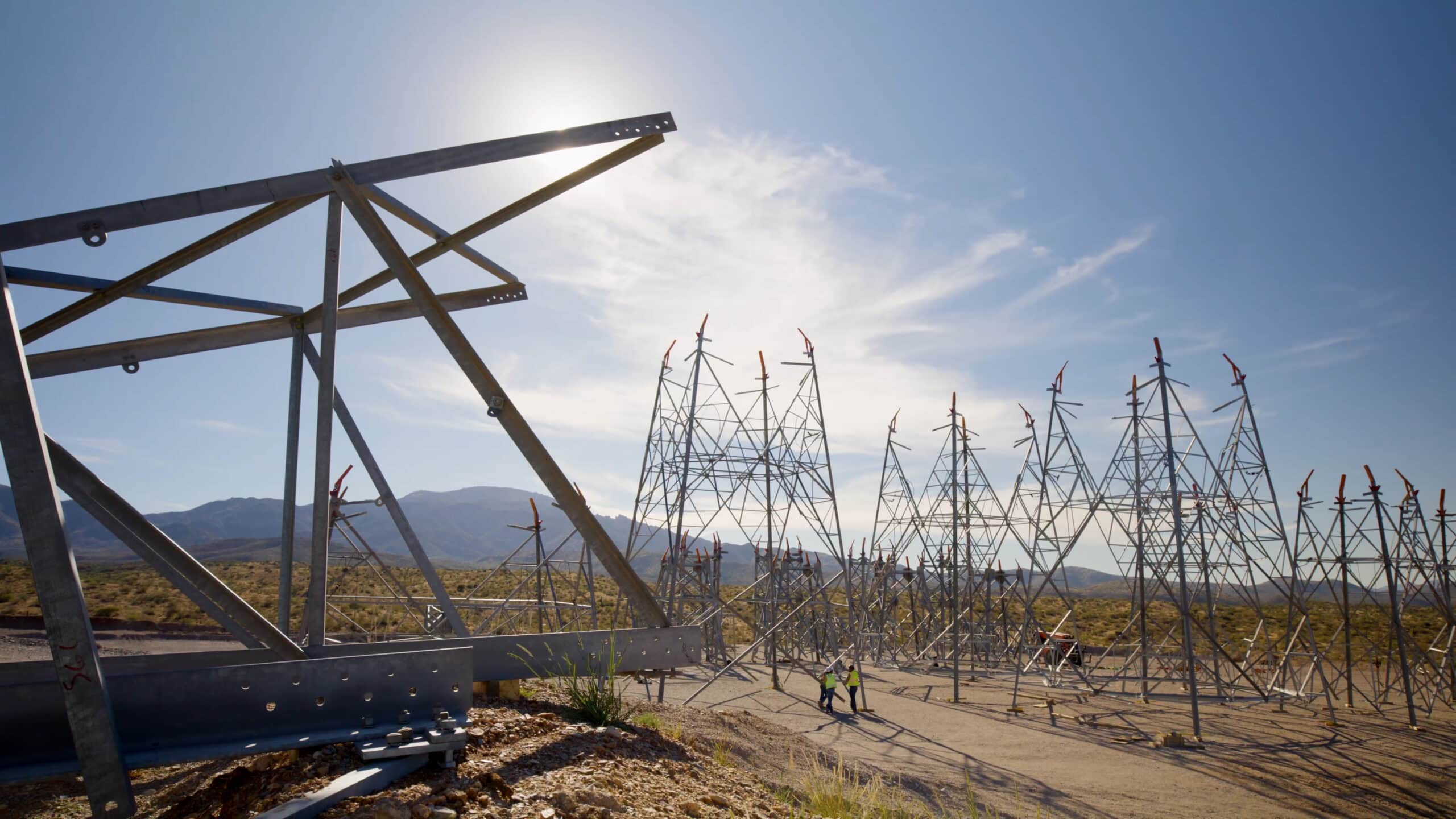

Structures Assembled – 100%
Structures Erected – 100%
Conductor Stringing – 100%
-

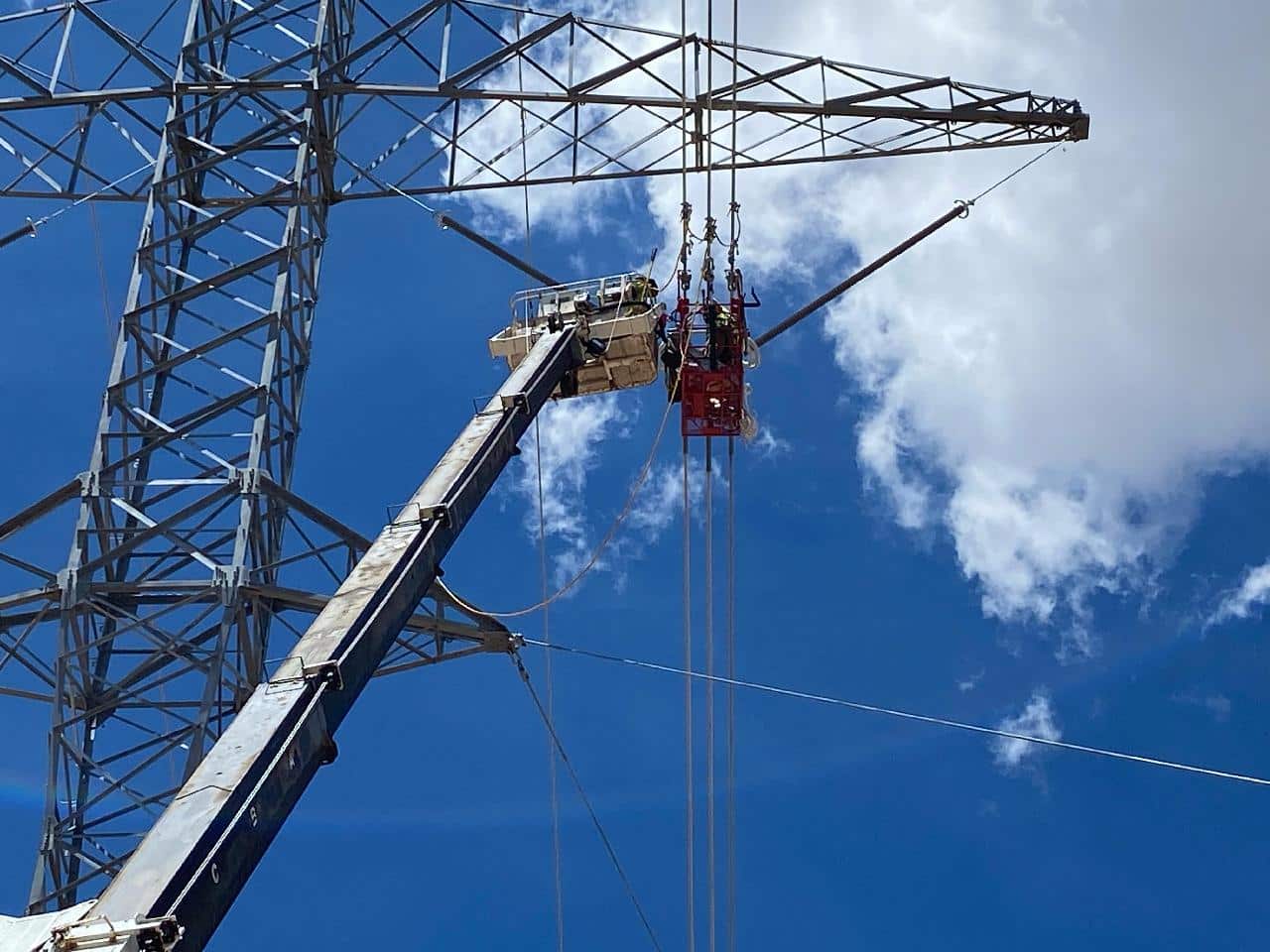

7/14/25 – HVDC East
HVDC Foundations – 695/100%
Cable Trenching System Installed – 3462/100%
AC Chopper Foundations – 223/100%
Yard Steel Erection – 468/97%
7/14/25 – HVDC West
HVDC Foundations 740/100%
Cable Trenching System Installed – 3408/100%
Yard Steel Erection – 512/100%
